San Diego Building Violation and Red Tag Compliance Services

How We Clear Building Violations and Red Tags in San Diego

Building violation resolution in San Diego requires synthesizing forensic structural engineering with strict municipal code compliance. MEE Builders executes targeted remediation for Priority I and II violations, utilizing advanced alternative compliance protocols to clear red tags, neutralize civil penalties, and secure fully legalized building permits.

Structural and Geotechnical Violations We Resolve in San Diego County

San Diego’s sophisticated regulatory environment and diverse geographic footprint require a high level of engineering precision. The region features highly localized microclimates and unique soil conditions that strictly dictate how residential and commercial structures must be built. When a property requires structural legalization or realignment with the San Diego Development Services Department (DSD), MEE Builders delivers impeccable, code-compliant solutions.

Operating centrally from 8400 Miramar Rd, Suite 200a, MEE Builders is positioned exactly 8 mins from the San Diego County Administration Center. This strategic logistical hub allows our engineering, framing, and plumbing crews to mobilize rapidly for emergency site inspections across Metro San Diego.

Whether resolving an unpermitted grading operation in Mission Valley or engineering a reinforced foundation in Rancho Santa Fe, our teams establish immediate site control. We master soil mechanics, coastal weather patterns, and the exact legal parameters required to satisfy city planners and secure your final approvals

Geologic Hazard Categories-130d443

Expansive Soil and Foundation Stabilization

A significant portion of structural non-compliance cases in San Diego traces back to subterranean soil mechanics. In inland communities such as North Park, Scripps Ranch, Poway, and the foothill corridors, the earth is heavily composed of expansive clay Vertisols—specifically the Diablo and Las Flores soil series. These dynamic soils contain high concentrations of smectitic minerals that expand during winter moisture events and contract violently during dry summers.

Over a home’s design life, this continuous kinetic stress can fracture unreinforced concrete slabs, shear wooden sill plates, and shift the structure out of acceptable municipal tolerances. When an inspector identifies visible structural deficiencies, MEE Builders executes a highly engineered rescue. We utilize heavy machinery to drill deep concrete caissons into stable, load-bearing strata, execute heavy-duty epoxy injection into the slab fractures, and install high-strength Laminated Veneer Lumber (LVL) beams. This anchors the shifting structure back into unyielding bedrock, flawlessly satisfying the DSD’s rigorous shear load and seismic design requirements.

Coastal Corrosion and Material Failure Repairs

Properties situated west of the I-5 corridor—from the marine terraces of Point Loma up through the coastal bluffs of La Jolla and Del Mar—require a totally different material science approach. The constant influx of airborne moisture, ambient humidity, and saltwater corrosion rigorously tests the structural envelope.

When Code Enforcement identifies that exterior walls or load-bearing supports have been compromised by moisture or pest intrusion, they cite the property for structural non-compliance. Resolving this requires a masterful forensic structural audit. We physically open the exterior walls, strip the compromised assemblies, and surgically excise the degraded timber.

We then rebuild the continuous load path utilizing premium pressure-treated, ACQ-rated lumber and heavy-duty structural sheathing. This guarantees the newly legalized structural envelope remains incredibly robust against the coastal atmosphere for decades to come

Rapid Mobilization for San Diego Priority Cases

The Building & Land Use Enforcement Division categorizes municipal investigations strictly based on public safety, assigning a specific priority level to each case.

Priority I violations—which include critical health and safety concerns such as leaking sewage, live exposed electrical wires, and unstable structures – require a physical inspection within one business day. Priority II violations, which include significant code deviations such as unpermitted additions, unpermitted grading, and disturbance of environmental resources, are inspected within 5 business days.

By operating a highly coordinated logistics hub on Miramar Rd, we understand how these localized enforcement tiers work. When a Priority I or II violation triggers a site visit, we deploy our fully licensed crews to establish immediate site safety, erect protective perimeters, and initiate the technical, professional dialogue with the city inspector.

This proactive approach demonstrates competence and immediately stabilizes the administrative process.

Priority I and Priority II Code Enforcement Response in San Diego

Receiving a formal Notice of Violation from the City of San Diego represents a critical juncture in your property’s history.

It indicates that the municipality has officially documented a breach of the San Diego Municipal Code (SDMC) and requires a professional, engineered response. MEE Builders is your central hub, combining structural engineering expertise and administrative fluency to navigate city planners effectively.

construction workers

Notice of Violation Requirements Under SDMC §12.0103

Under the provisions of SDMC §12.0103, a Notice of Violation is the formal administrative document that initiates the compliance process. Whenever an Enforcement Official determines that a property requires correction under the Municipal Code or applicable state codes, they issue this notice to the Responsible Person.

This highly specific document outlines the exact street address, the specific code sections requiring attention, a detailed description of the site conditions, and a strict deadline for correction. MEE Builders treats this document as a blueprint for property optimization. We immediately execute a comprehensive compliance audit, cross-referencing the inspector’s physical claims against historical archival blueprints pulled directly from DSD records. Often, in classic San Diego neighborhoods, we can prove preexisting legal non-conforming status using historical data, clearing specific line items off the notice efficiently.

How Building Violations Affect Property Title and Equity

If a property remains in non-compliance after the established deadline, the administrative process advances. Under SDMC §12.1003, the Director possesses the authority to officially record the Notice of Violation directly with the Recorder’s Office of San Diego County.

Recording the notice effectively clouds the property’s title, which can halt real estate transactions or refinancing efforts. Before the city records the notice, they must provide the Responsible Person with a letter indicating their intent to record, outlining the opportunity to file a written appeal within 10 calendar days.MEE Builders proactively manages this scenario. We compile the necessary technical documentation, open a constructive dialogue with the inspector, and produce the highly accurate “as-built” CAD blueprints required to initiate retroactive permitting. This effectively preserves the owner’s clear title and validates the property’s full market value

Mitigating Municipal Fines And Civil Penalties Through Proactive Engineering

Resolving a building violation promptly is the most effective way to protect your financial investment. The San Diego Municipal Code utilizes specific mechanisms to encourage timely compliance. Understanding the distinction between an Administrative Citation and a Civil Penalty allows us to deploy the correct strategy to protect your assets.

Administrative Citations for Building Code Violations

Authorized by SDMC §12.0903, the Administrative Citation program is a method of enforcement designed for ongoing code deviations that do not necessarily create an immediate danger but require correction.7

If the responsible party fails to correct the issue after an initial warning, the enforcement officer issues a citation, typically starting at $100.8. Subsequent citations for uncorrected issues escalate to $200, then $500, maxing out at $1,000 per violation, with a maximum of $10,000 in fines for each specific violation per year.8 SDMC §12.0903 notes that “each and every day a violation of the Municipal Code or applicable state code exists constitutes a separate and distinct offense”.7 MEE Builders halts this process by rapidly deploying crews to rectify the cited infractions, bringing the property back into perfect alignment with municipal expectations.

images (44)

Civil Penalties and Daily Fine Exposure

For more complex Priority I or II violations where progress has stalled, the city may utilize Civil Penalties pursuant to SDMC §12.0202 and §12.0805.

The Director or an Administrative Enforcement Hearing Officer has the authority to assess civil penalties at a daily rate of up to $10,000 per violation, per day, up to a maximum of $400,000 per parcel. To mitigate these assessments, you need a contractor capable of executing immediate, code-compliant abatement. By pulling the emergency structural permits, trenching the site, and installing the required Laminated Veneer Lumber (LVL) beams or deep foundation caissons, MEE Builders proves to the city that active, professional remediation is underway, demonstrating good faith and effectively freezing the assessment of further penalties.

Appeals and the 10-Day Deadline

Under SDMC §12.0501, a property owner served with an Administrative Citation or an Intent to Record a Notice of Violation possesses 10 calendar days from the date of service to file a formal appeal. (Note: The City of San Diego strictly enforces a 10-day window for these specific notices 11).

MEE Builders assists in preparing the impeccable technical documentation required for Administrative Hearings. We compile the structural engineering reports, the geotech soil data, and the forensic photographic evidence needed to present a highly professional, data-driven case, providing the technical backup required to negotiate timeline extensions and successfully resolve the file.

San Diego Code Enforcement Escalation Timeline

1- Inspection

Priority I Cases (Imminent Health & Safety Hazards)
Inspected within 1 business day.

Priority II Cases (Significant Code Violations)
Inspected within 5 business days.

Served as a strict prerequisite to an administrative citation. The warning identifies the violation, provides instructions on how it can be corrected, and explicitly specifies a time and date deadline by which the violation must be resolved.

Issued if the violation is not fully corrected by the warning deadline. The County may impose escalating fines and late payment charges.

Furthermore, the County can impose a code enforcement lien upon the real property until all costs are fully paid.

Assessed at a daily rate. The maximum rate reaches $10,000 per violation, per day. The total amount of civil penalties is capped and shall not exceed $400,000 per parcel or structure for any related series of violations.

The final escalation. The City may direct a third party to forcefully demolish, secure, or remove junk and debris. The City will subsequently recover all incurred costs directly from the property owner

How We Restore Legal Status and Prevent Municipal Action

In cases involving extreme structural instability or severely compromised, unpermitted structures, the municipality may utilize an Abatement Warrant to initiate physical property intervention. MEE Builders prevents this by taking absolute, professional control of the site.

Preventing Public Nuisance Abatement

Under the procedures outlined for the abatement of unsafe or unpermitted structures, an Abatement Warrant grants the city the authority to enter private property and forcibly correct the violation.

The city may execute a Public Nuisance Abatement, hiring a third-party firm to tear down the unpermitted structure or secure the site. The costs for these third-party contractors, plus municipal administrative fees, are billed back to the property owner and can result in a code enforcement lien directly against the real estate. MEE Builders acts as your premier defense against this outcome. We deploy our excavation and framing crews to systematically dismantle or reinforce the hazardous conditions under our own controlled, highly engineered protocols. By performing the work internally, we bypass the costly third-party municipal process, preserving your physical assets and ensuring the highest construction quality.

construction workers

Establishing Compliance Under SDMC §121.0311

San Diego Municipal Code §121.0311 provides the city with broad remedies to enforce the Land Development Code, holding owners strictly liable for all code violations occurring at their property, However, this same rigid code framework provides the mechanisms for achieving flawless compliance. We engage directly with the Building Official to demonstrate that a licensed, bonded Class “B” General Building Contractor has established absolute site control. By producing highly detailed, scale architectural plans drawn to exactly match the 2026 California Residential Code (CRC) and Title 24 energy mandates, we seamlessly transition the property out of the litigation phase and back into standard permitting workflows

Establishing Compliance Under SDMC §121.0311

In complex scenarios requiring technical clarification on building standards, the San Diego Board of Building Appeals and Advisors serves to hear appeals regarding the administration of the code

Furthermore, under state law, parties can appeal interpretations of a building standard to the California Building Standards Commission (CBSC), provided local appeal processes are exhausted. MEE Builders understands the deep technical language required to navigate these boards. We construct the forensic arguments, cite the exact shear strength data, and provide the engineering reports necessary to validate your structure’s integrity and secure your legal approvals.

Permitting Strategies to Legalize Unpermitted Construction

Not every building violation requires starting from scratch. Our primary strategic focus when dealing with complex code violations is to utilize advanced administrative negotiation to secure realistic, engineered pathways to legalization.

Board of Building Appeals and Advisors Process

When a Notice of Violation is issued, we immediately engage the assigned enforcement officer to establish a formal Compliance Schedule.

A Compliance Schedule is a legally recognized timetable provided to the property owner based on the realistic timeframes required by a professional permit applicant to complete heavy structural tasks.8 The city strives to provide flexibility and achieve voluntary compliance, provided they see proof of competence.8

We provide the inspector with a highly detailed, professional Gantt chart outlining the exact dates for civil engineering plan submittals, monolithic concrete pour schedules, and final inspections. By proving our mastery of continuous load path corrections, we seamlessly secure the critical breathing room necessary to pull the correct permits and execute a flawless physical build.

Executing Alternative Compliance (Form DS-104)

In heavy structural engineering, Alternative Compliance refers to a highly technical building code procedure utilized when adhering to the exact prescriptive code is physically impossible due to preexisting site constraints. (Note: This is distinct from the neighborhood-level mediation process also called “Alternative Compliance” for minor complaints ).

Utilizing Form DS-104 (Application – Alternate Materials, Design or Construction Methods or Code Modification), our structural engineers submit a formal request to the DSD.22 We legally substantiate that our proposed alternate design is equivalent to the prescribed standards in terms of suitability, structural strength, fire resistance, and safety.

For example, if a previous owner removed a load-bearing shear wall to create an open-concept layout, we engineer an Alternative Compliance solution. We install a massive structural steel I-beam or a steel moment frame in the ceiling cavity, exceeding the original wall’s lateral shear load requirements while preserving the modern aesthetic.[1, 1, 1] We submit the precise deflection calculations to the Building Official via Form DS-104, legalizing the modification with absolute structural brilliance.

Project Issue Resolution (PIR) Conferences

If a technical conflict arises between our engineering team and a city plan reviewer, we utilize the DSD’s escalation protocols. We start with a Guaranteed Second Opinion.

If the issue remains after the third cycle of review comments, we formally request a Project Issue Resolution (PIR) Conference.

glass
Paths-to-Your-Dream-Space

A PIR Conference elevates technical project issues directly to the Executive Management Team. At this meeting, relevant city staff, our design professionals, and the applicant convene to break the review logjam.

 We utilize this process to push through complex structural tie-ins, ensuring your project advances swiftly through the permitting phase.

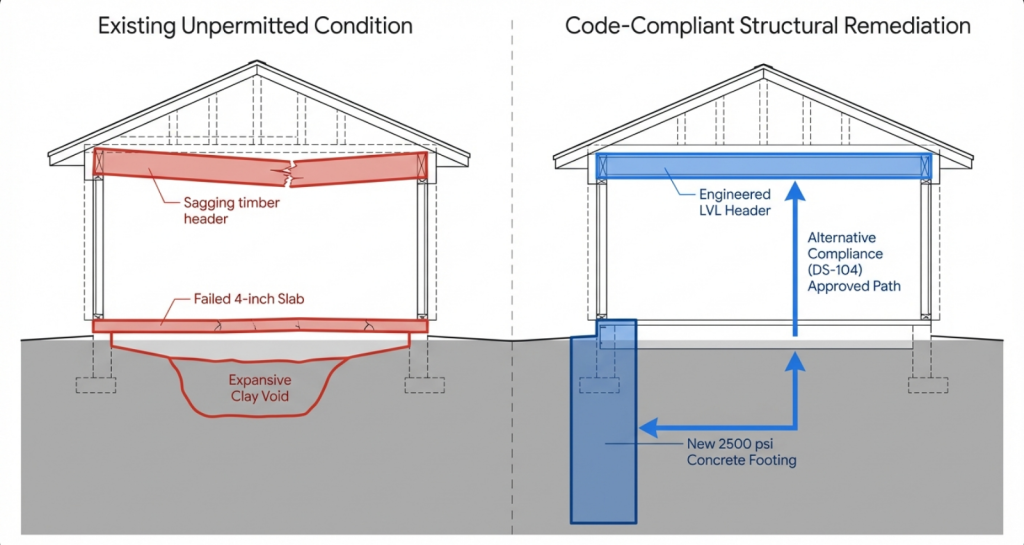

Forensic Structural Remediation: Achieving Alternative Compliance

When standard framing fails code requirements, MEE Builders engineers Alternative Compliance solutions – such as deep-drilled caissons and steel moment frames – to intercept continuous load paths and satisfy municipal shear strength mandates.

Securing Change Of Record Approvals To Resume Stalled Construction Projects

Occasionally, we are hired to elevate projects that were poorly managed by previous contractors who deviated from the city-approved blueprints. When a city inspector identifies that the physical construction does not match the stamped plans, they issue a stop-work order. MEE Builders smoothly resolves these discrepancies.

The IB-118 Construction Change Framework

To correct a mid-project deviation efficiently, we leverage the administrative framework of Information Bulletin 118 (IB-118)

Under Municipal Code Section 129.0214, approved plans shall not be changed without the explicit authorization of the Building Official.26 IB-118 describes the precise procedures for obtaining approval for changes to construction plans that have already been approved.

We deploy our drafting team to map the exact on-site physical realities. We then submit a formal Construction Change package electronically via the OpenDSD portal.26 This package includes revised structural calculations and updated PDF plans with the brilliant new engineering changes clearly marked.

We manage the non-refundable hourly plan check fees required to expedite the review, legalizing the necessary on-site pivots and allowing construction to resume safely.

Executing Form DS-342 for Change of Record

When taking over a project, we must officially establish our authority. We utilize Form DS-342 (Change of Building Permit Record).

 This form is legally required when there is a change of the property owner, contractor, permit holder, or the licensed design professional of record. By filing this form in conjunction with the IB-118 construction changes, we officially establish MEE Builders as the sole responsible party, assuming total control over the exceptional quality of the inspections and final sign-offs.

Validating Additions and Retroactive Permitting

San Diego’s classic housing stock frequently features undocumented, unpermitted additions. When a homeowner attempts to sell or remodel the estate, these liabilities are exposed.

We proactively manage these scenarios utilizing retroactive permitting processes outlined in San Diego’s Information Bulletin 242

We strategically expose the framing and verify the electrical wire gauges directly for the city inspector. We then execute the physical structural modifications necessary – such as upgrading undersized floor joists or installing Title 24-compliant fenestration – to bring the existing assembly up to the impeccable standards of the 2026 life-safety codes. This transforms undocumented spaces into fully permitted, heavily appraised square footage.

Administrative Tool

DSD Form / Bulletin

Primary Function in Violation Resolution

Alternative Compliance

Form DS-104

Proves an alternate structural design or material provides equivalent safety to the prescriptive building code.

Construction Changes

Information Bulletin 118

Legally alters approved blueprints mid-project without starting the permitting process over.

Change of Record

Form DS-342

Legally removes a previous contractor from a permit and establishes MEE Builders as the responsible party.

Retroactive Permitting

Information Bulletin 242

Validates and legalizes older, unpermitted additions by upgrading to current 2026 life-safety codes.

Upgrading Non-Compliant Systems To 2026 Title 24 And Life-Safety Codes

Unlike standard general contractors, MEE Builders offers dedicated Forensic Construction Services. We deploy rigorous engineering and diagnostic protocols to isolate the exact root cause of a code violation and engineer a permanent, unyielding enhancement to the property.

Advanced Diagnostic Equipment and Testing

To provide definitive structural evidence, our operations rely on specialized equipment. When evaluating moisture intrusion that has led to a structural hazard citation, we utilize advanced Infrared Technology and EIFS Moisture Meters. These non-destructive inspection tools allow our engineers to photograph hidden areas to identify exact moisture intrusion points around flashing and fenestration.

When evaluating foundation requirements in large-scale properties, forensic structural engineers perform rigorous tactile inspections. We physically evaluate the underlying shear wall nailing patterns, inspect for saltwater corrosion on structural steel elements, and verify construction compliance. We document everything, providing the comprehensive reporting necessary to clear the violation and satisfy the most rigorous municipal demands

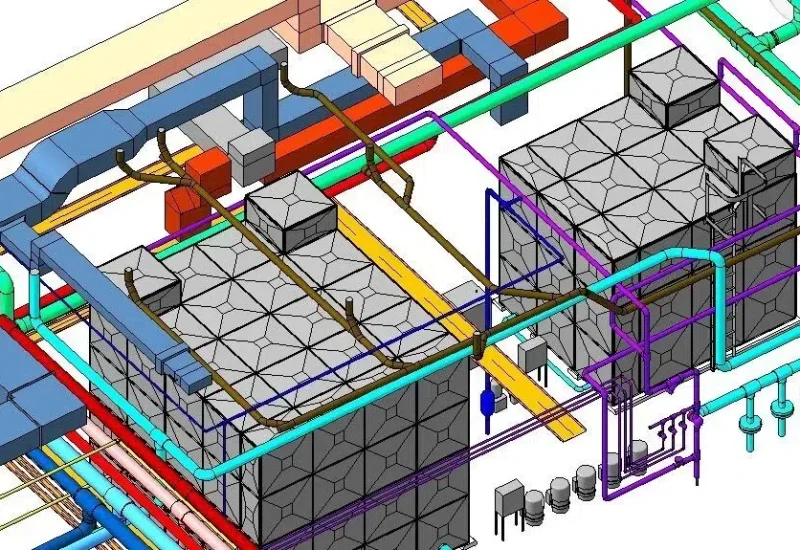

Modernizing Non-Compliant MEP Systems

A significant portion of Priority I violations stem from aging mechanical, electrical, and plumbing (MEP) systems.

When a property is cited for sewage leaks, we perform deep infrastructure trenching to replace the rusted legacy cast-iron pipes.

We install high-durability ABS waste lines, ensuring a pristine, mathematically perfect 1/4-inch per foot slope. We simultaneously modernize the supply manifolds with premium PEX-A (cross-linked polyethylene) piping, guaranteeing decades of high-volume, unrestricted flow and neutralizing the violation entirely.

When a property is cited for live, exposed electrical wires, we execute an emergency electrical modernization. We coordinate directly with the utility provider to upgrade the property’s main service to a robust 400-amp electrical panel system.

We pull entirely new, heavy-gauge copper home runs throughout the exposed wall cavities, integrating the latest Arc Fault Circuit Interrupters (AFCIs) and Ground Fault Circuit Interrupters (GFCIs). This ensures the infrastructure complies perfectly with the 2026 Title 24 electric-ready mandates, restoring safe power to the estate.

How-MEP-Systems-Affect-Every-Building-Decision-with-Architectural-Teams
Purpose of MEP Systems

Elevating Title 24 Building Envelope Compliance

Unpermitted exterior modifications frequently violate the 2026 California Title 24 Energy Code updates.[1, 1] If a homeowner installs unpermitted, single-pane windows, the DSD will issue a citation.

We strip the compromised assemblies
enestration products that meet a rigorous maximum U-factor rating of 0.30 or lower, paired with specialized low Solar Heat Gain Coefficients (SHGC).

Once the envelope is meticulously sealed, we schedule the mandatory HERS (Home Energy Rating System) diagnostic blower-door test with an independent third-party rater.
This guarantees the city inspector receives the exact mathematical compliance documentation required.

Centralized Project Authority For Flawless San Diego Violation Resolution

When you are dealing with the legal intricacies of municipal permitting and complex structural engineering, you cannot afford to work with a disjointed corporate entity. Corporate project manager hand-off errors can result in delays and misinterpretations of structural load paths.

Impeccable Execution Through Direct Owner Oversight

MEE Builders operates under a strictly unified, direct-response operational model.We provide a centralized point of authority under the direct, daily oversight of owner Yaron Gauzner. With a 10-year track record navigating the specific bureaucratic nuances of the San Diego market, we eliminate communication lag entirely.

The exact same professional who analyzes the structural load paths of your Laminated Veneer Lumber (LVL) beams during the initial drafting phase is actively orchestrating the on-site monolithic foundation pour and negotiating directly with the Code Enforcement officer. We meet the inspectors armed with exact deflection tolerances, precise Floor Area Ratio (FAR) mathematics, and a complete, nuanced mastery of the California Building Standards Code.

construction workers

The Anti-Generalist Approach to Structural Brilliance

We operate exclusively as the “Anti-Generalist.” We reject standard, superficial fixes in favor of executing deep, uncompromising civil engineering.

If an unpermitted load-bearing wall removal has caused second-story floor joists to sag, we install heavy-duty, laser-leveled shoring walls to intercept the massive dead weight.We then pour massive new steel-reinforced 2,500 psi concrete footings, and hoist structural Steel I-Beams perfectly flush into the ceiling cavity.The vertical load is tracked perfectly through heavy timber trimmers and driven securely into the newly stabilized earth.This level of structural brilliance ensures the final assembly vastly exceeds current life-safety codes.

CSLB Class-B Compliance and Ultimate Project Authority

Undertaking heavy structural modifications requires absolute legal authority. The California Contractors State License Board (CSLB) explicitly prohibits restricted “B-2” remodeling contractors from making structural changes to a building.

MEE Builders operates under strict CSLB #1046249 Class “B” General Building Contractor compliance.
We assume total legal responsibility for the heavy structural engineering, the retroactive permit negotiations, and the flawless execution of your remediation. We elevate your property with impeccable structural engineering, securing your final permit sign-offs and permanently closing the file on your building violation.

Call for a Premium Code Enforcement Site Assessment.

Frequently Asked Questions: Navigating San Diego Code Enforcement

What is the cost of neglecting a Priority I building violation in San Diego for another year?

The maximum penalty is $10,000 per violation, per day, capping at $400,000 per parcel. After the initial 10-day appeal window closes, the San Diego Development Services Department (DSD) aggressively enforces these Civil Penalties for unresolved infractions. MEE Builders halts this financial bleed by immediately trenching the site and installing deep foundation caissons to prove active, code-compliant abatement is underway.

Because the city inspects Priority I hazards within one business day, it takes our crews exactly 30 minutes to mobilize to emergency site inspections in Metro San Diego. Operating from our logistical hub on Miramar Rd, our Class “B” General Building Contractor teams deploy instantly to secure the perimeter. We immediately mitigate imminent public safety hazards like exposed electrical wiring or failing Laminated Veneer Lumber (LVL) beams before the city escalates to an Abatement Warrant.

We perform highly controlled destructive testing to physically evaluate the underlying shear wall nailing patterns and structural load paths. For unpermitted additions compromised by moisture, our engineers utilize advanced Infrared Technology and EIFS Moisture Meters to map water intrusion without tearing down the entire structural envelope. We then produce the comprehensive “as-built” CAD blueprints required by the city planners to begin the retroactive permitting process.

Expansive clay Vertisols generate immense upward hydrostatic pressure that fractures unreinforced concrete slabs. In inland corridors like Scripps Ranch and Poway, this dynamic soil movement throws wood-framed structures entirely out of plumb, quickly triggering structural instability citations. We engineer a permanent solution by drilling deep concrete caissons into unyielding bedrock and executing heavy-duty epoxy injection to stabilize the continuous load path.

An Administrative Citation maxes out at $10,000 annually, while a Civil Penalty costs up to $10,000 per day. The DSD leverages administrative citations for ongoing code deviations, but deploys the daily civil penalty hammer for stalled Priority I or II structural hazards. We protect your property equity by filing the necessary Form DS-104 for Alternative Compliance and establishing a legally recognized compliance schedule to freeze these escalating municipal assessments.

No, the California Contractors State License Board (CSLB) explicitly prohibits unlicensed labor or restricted B-2 contractors from executing heavy structural modifications. Attempting to repair a failing foundation or unpermitted load-bearing wall removal without proper civil engineering guarantees a failed municipal inspection and accelerates the threat of Escrow Paralysis. MEE Builders assumes total legal authority for your remediation, installing the mandated structural Steel I-Beams and securing final permit sign-offs.

You must file a formal written appeal within exactly 10 calendar days of receiving the enforcement notice. Failing to appeal authorizes the Director to record the Notice of Violation directly with the San Diego County Recorder’s Office, effectively clouding your property title. We step in immediately to assume site control, providing the city inspector with precise Gantt charts for upcoming monolithic concrete pours and bringing the property back into legal alignment

Yes, we legally validate and permit undocumented additions utilizing Information Bulletin 242 protocols. We strategically expose the hidden framing, verify the electrical wire gauges directly for the city inspector, and upgrade undersized floor joists to meet the uncompromising 2026 California Residential Code (CRC) standards. This proactive forensic construction translates undocumented liabilities into fully permitted, heavily appraised square footage.
